Spring 2017 Preliminary Project Plan: Prosthetic Hand

The Robot Company | CEO Professor Gary Hill

Project Manager: Bianca Esquivel | Mission, Systems, and Test Engineer: Chris Bautista

Electronics and Control Engineer: Forest Nutter | Manufacturing Engineer: David Mendoza

Table of Contents

Prosthetic Hand Project WBS

by Bianca Esquivel (Project Manager)

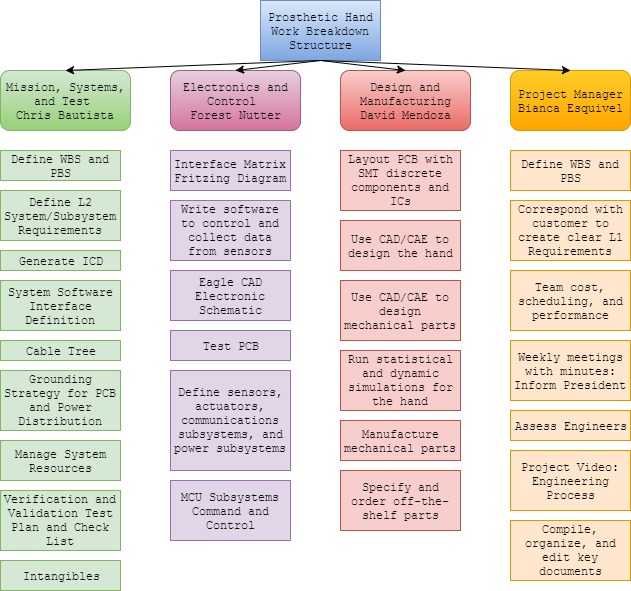

Work Breakdown Structure

This is a hierarchical breakdown of the work that is necessary to complete the project, i.e. building the prosthetic hand. This coincides with the Product Breakdown Structure (PBS) located in the Preliminary Design Document:

Product Breakdown Structure

As well as also reflecting the tasks assigned to each position in the company matrix.

Project Schedule

by Bianca Esquivel: Project Manager

Top Level Schedule

The Top Level Schedule was created in Project Libre, it is a combination of a Spreadsheet and of a Gantt Chart to exhibit the schedule from today (March 3rd, 2017) to the End of the Semester, and therefore, the End of the Project (May 19th, 2017). All the tasks listed in the Top Level Schedule reflect the tasks that need to be completed based off of the Work Breakdown Structure (WBS) provided above.

Top Level Schedule Spread Sheet – Hand

Top Level Schedule Gantt Chart – Hand

Project Burndown

by Bianca Esquivel: Project Manager

Project Progress
Define Sensors, Actuators, etc. - Rapid Prototype
Software Control - Rapid Prototype
MCU Command & Control - Rapid Prototype

Burdown

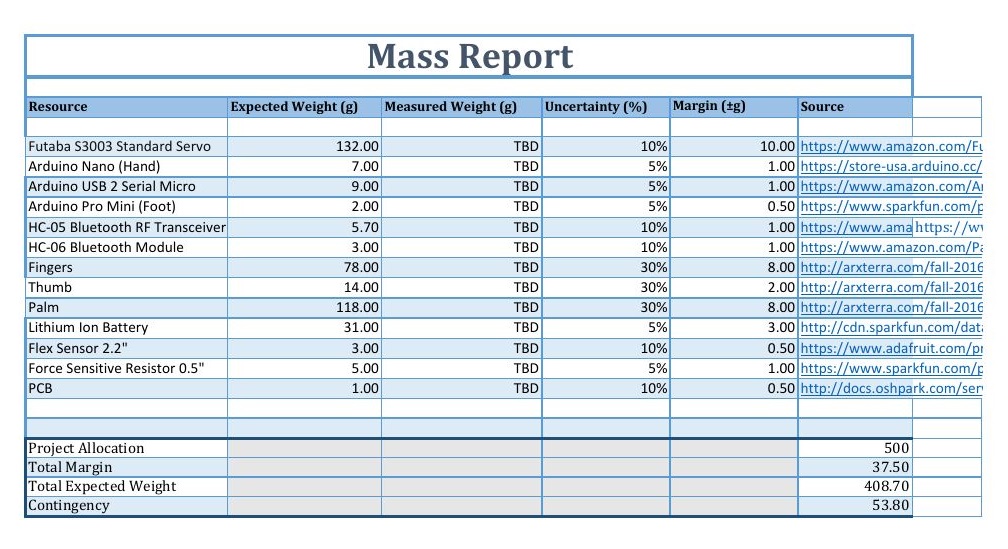

System Resource Reports

by Chris Bautista: Mission, Systems, and Test Engineer

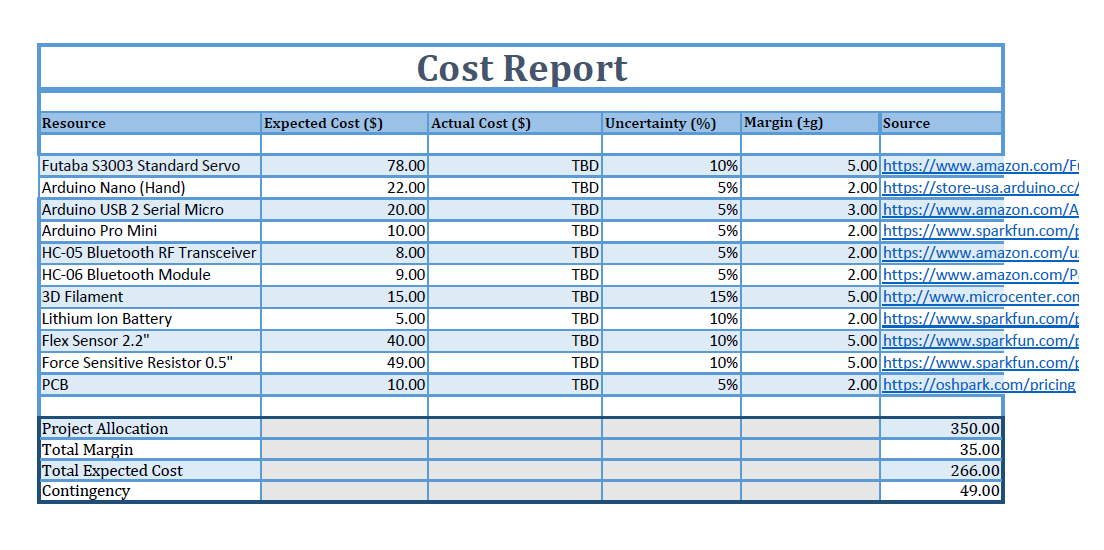

Project Cost Estimate

by Chris Bautista: Mission, Systems, and Test Engineer
